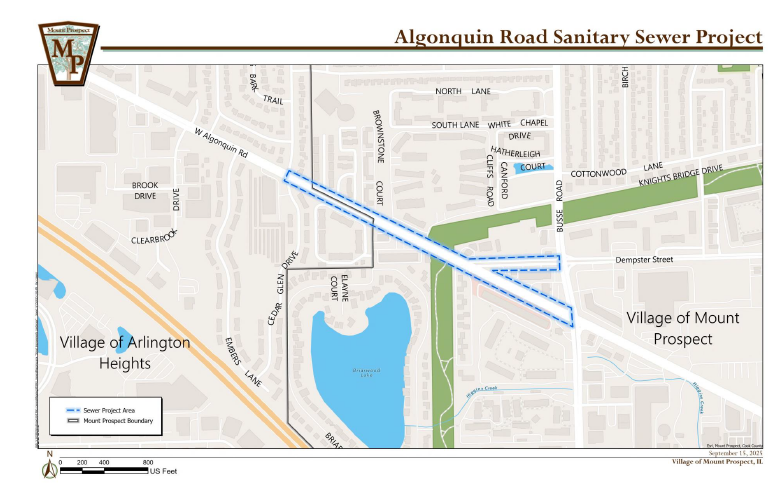

Algonquin Road Sewer Improvement Map
In the fall of 2025, The Village of Arlington Heights started the installation of sanitary sewer pipe along Algonquin Road from Busse Road to Cedar Glen Drive. The project limits also include work along Dempster Street between Busse Road and Algonquin Road. The project will replace approximately 2,500 feet of sanitary sewer with a larger-diameter pipe to increase the capacity of the system. All affected private sanitary sewer service lines will be connected to the new sewer. The Village of Arlington Heights and the contractor will coordinate the reconnection of private service lines with affected businesses.

This project is a Village of Arlington Heights capital improvement project. More information regarding the project can be found on the Village of Arlington Heights webpage at:
https://www.vah.com/government/departments/public_works/algonquin_road_sewer_improvement.php
Phase I April 15 – April 30
Algonquin Road from Busse Road to Dempster Street

Road Closure/Detour
Westbound lanes on Algonquin Road detoured to northbound Busse Road, westbound GolfRoad, southbound Arlington Heights Road

Phase II May 1 – May 15
Algonquin Road at Dempster Street intersection

Road closure/detour
Westbound lanes on Algonquin Road detoured to northbound Busse Road, westbound Golf Road, southbound Arlington Heights Road
Westbound lanes on Dempster Street detoured to northbound Busse Road, westbound Golf Road, southbound Arlington Heights Road
Eastbound lanes on Dempster Street detoured to eastbound Algonquin Road, northbound Elmhurst Road

Phase III May 16 – June 30
Algonquin Road from Dempster Street to Cedar Glen Drive

Road Closure
No detour, westbound Algonquin Road lane closure

Phase IV July 1 – July 15
Dempster Street from Busse Road to Algonquin Road

Road Closure/Detour
Westbound lanes on Dempster Street detoured to southbound Busse Road, westbound Algonquin Road

Phase V July/August 2026
Final cleanup & restoration
April 7, 2026
Work is expected to resume the week of April 15th and be completed in Summer 2026.

March 16, 2026
The Algonquin Sewer Capacity Improvement Project starts on April 15, 2026. This is a continuation of last year’s project to increase the size of the sanitary sewer from Dempster Road to South Cedar Glen Avenue.

Please be advised, lane closures are planned for Wednesday, April 15, 2026, as the project enters its final phase. Advanced warning message boards will be posted beginning Wednesday, April 1, 2026.

The road closure will be for the west bound traffic lanes from Busse Road to Dempster Street, advancing west, as construction progresses, from Dempster Street to the west. The project and closure are anticipated to be completed by August 1, 2026, provided no significant issues and weather permitting.
