In 2026, we are scheduled to resurface and improve 6.99 miles of the overall 137 miles of roadway within the Village network. The 2026 Program is divided into 2 projects, Group 1 and Group 2. The Group 1 project will improve 3.69 miles of roadway. The Group 2 project is coordinated with the Water Main Improvement project and consists of 3.3 miles of roadway.
What Type of Work Will be Completed?
- Repair storm inlets and catch basins.
- Replace deteriorated curbs, sidewalk squares and sidewalk ramps.
- Restore portions of driveway aprons that are removed due to construction activities.
- Restore parkways disturbed by construction with topsoil and seed.
- Mill existing pavement to proposed depth.
- Replace pavement with new asphalt.
- Restore pavement markings to road surface.
WATER MAIN REPLACEMENT PROJECT
In conjunction with our resurfacing program, Public Works water and sewer will be replacing water mains on the following Group 2 resurfacing roadways:
- S. School Street (Northwest Highway – Busse)
- S. Wa Pella Avenue (Lincoln – Central)
- S. Tower Lane (Tower Dr – end of cul-de-sac)
- S. Tamarack Drive (Catalpa – Willow)
- W. Willow Lane (Tamarack – Busse)
- W. Willow Lane (Busse – Church)
- S. Redwood Drive (Dempster – Cottonwood)
- W. Cottonwood Lane (Redwood – Linneman
Please note that the water main work will occur first and once complete, be followed by the Group 2 resurfacing project. Any outstanding restoration, curb and gutter, sidewalk, driveway and drainage work will be completed by the resurfacing project.
More information about the Water Main Replacement Project can be found on our site.

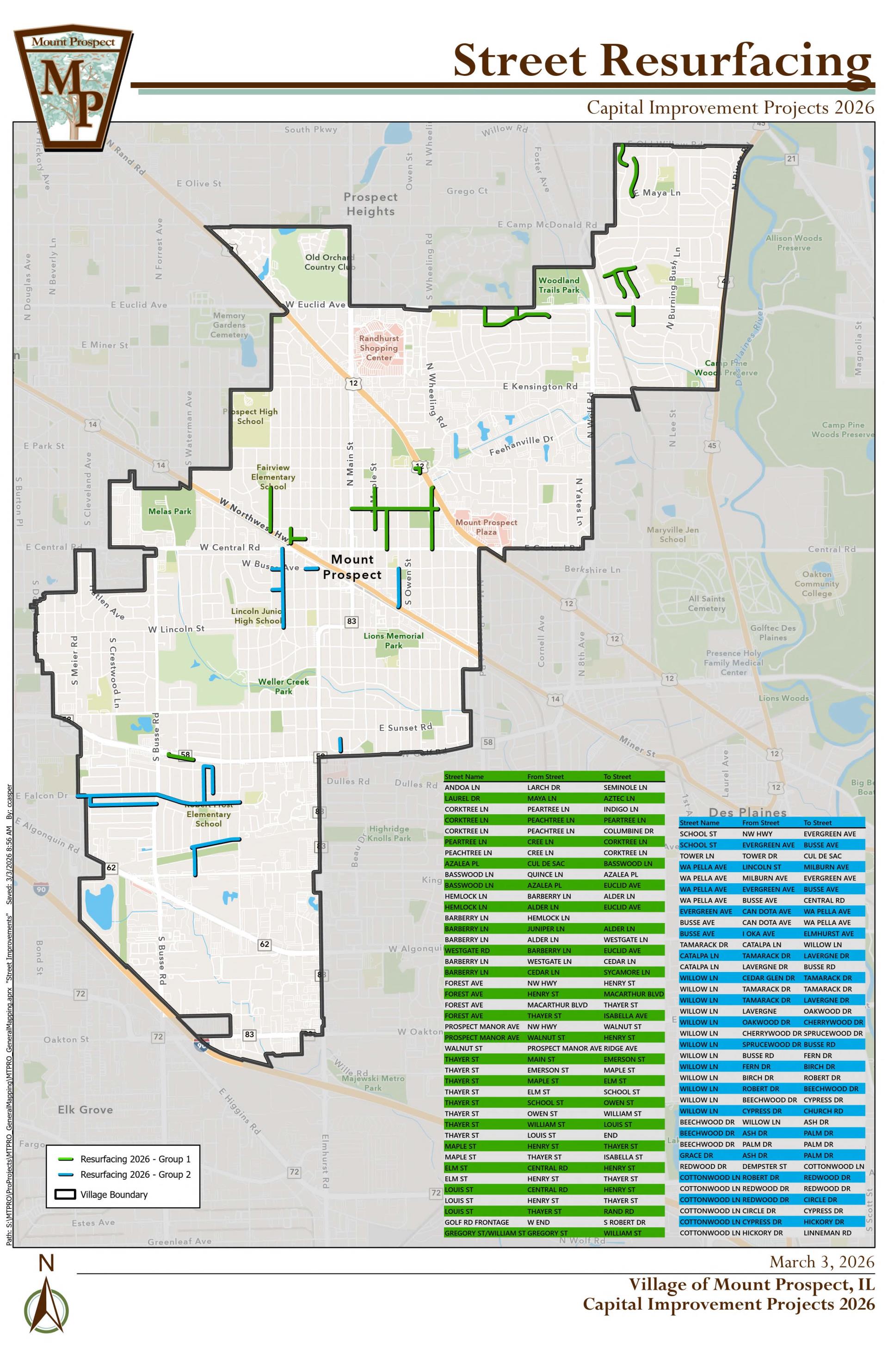

Week of April 13 (Map of work scheduled)
Sawcutting activities will continue on the following Streets:
- E Thayer St (Main St to East End)
- Gregory St & William St Intersection
Sidewalk Removals will begin in Section A
Week of April 6
Sawcutting activities will occur on the following streets:
- Hemlock Ln (Barberry Ln to Alder Ln and Alder Ln to Euclid Av)
- Westgate Rd (Barberry Ln to Euclid Av)
- Barberry Ln (Hemlock Ln to Sycamore Ln)
- E Thayer St (Main St to East End)
- N Maple St (Henry St to Isabella St)
- N Elm St (Central Rd to E Thayer St)
- N Louis St (Central Rd to Rand Rd)
Week of March 30: (Map of work scheduled)
Sawcutting activities will occur on the following streets:
- Andoa Ln (Larch Dr to Seminole Ln)
- Laurel Dr (Maya Ln to Aztec Ln)
- Corktree Ln ( Indigo Ln to Peartree Ln, Peartree Ln to Peachtree Ln, and Peachtree Ln to Columbine Dr)
- Peartree Ln (Cree Ln to Corktree Ln)
- Peachtree Ln (Cree Ln to Corktree Ln)
- Azalea Pl (Cul De Sac to Basswood Ln)
- Basswood Ln (Quince Ln to Azalea Pl and Azalea Pl to Euclid Av)
- Hemlock Ln (Barberry Ln to Alder Ln and Alder Ln to Euclid Av)
- Westgate Rd (Barberry Ln to Euclid Av)
- Barberry Ln (Hemlock Ln to Sycamore Ln)
Overview :
January 2026 - Let Group 1 and Group 2 Resurfacing Bids.
February 2026 - Award Group 1 and Group 2 Resurfacing Contracts.
April 2026 - Construction to Start
October 2026 - Substantial Completion
November 2026 - Final Completion
Eric Grzeskowiak, P.E., PTOE
Project Engineer
Village of Mount Prospect
Phone: 847-870-5640
